Tuesday, November 6, 2012

W2_Ocharlie_Why does a WBS oriented by element of cost cause problem when used for EVM


Problem definition

Determine why a WBS oriented by element of cost or organisational element cause problems when used for earned value management

Feasible alternatives

WBS with cost element orientation

WBS with organisational orientation

WBS with product-oriented

Develop the outcome of each alternative

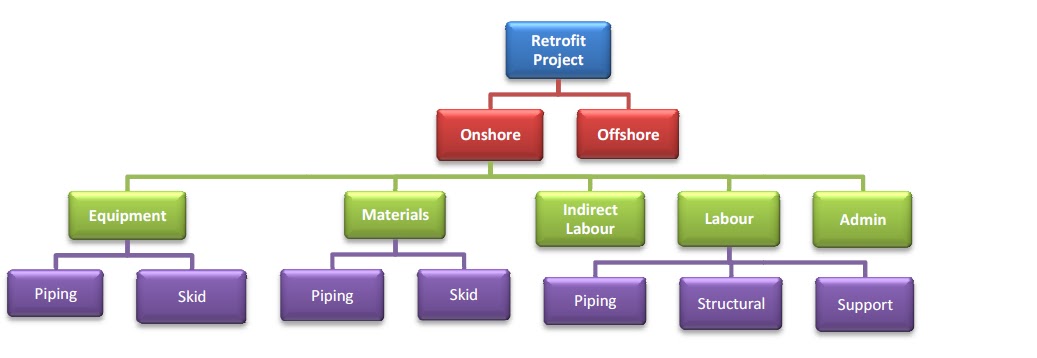

 Fig. 1 Cost Oriented WBS





Fig. 2 Product oriented WBS



Fig. 3 Organisation oriented WBS

Selection of criteria

Ease of assessment of progress status

Ease of communication

Bases for historical data

Analysis of alternatives

Consider figs 1,.2 and 3 above,

With the product oriented approach of fig 2, the logical level 2 WBS elements were Skid, Pipe spools and paint. Questions on status of the project are easily explained by the status of the skid, the spools and paint. A glance on the report shows where the project is.

The cost oriented WBS shown in fig.1, the status of the skid, pipie spools and paint is fragmented into multiple control accounts of equipment, materials, labour, indirect and administrative. Obtaining the status for the skid for instance entails collecting data from all the cost legs and summing up. This becomes cumbersome where you have multiple key elements of the project.

The organisational oriented approach of fig. 3 contains some redundant information. The 2 main element in the project skid and pipe spools cannot be easily assessed as this is not the function of OBS. Using OBS in WBS negates the value purpose as information are duplicated.

Selection of preferred alternative

Earned Value Measurement is a project control tool that focuses on earned value of work performed as project progresses and allows for effective measurement of the status in terms of both cost and schedule. In the three scenarios in figs. 1 to 3 it is clear that only fig.2 gives a visible status of the project in terms of the 2 main level 2 elements- skid and pipe spool fabrications. Therefore product oriented WBS is unambiguous project control tool in earned value measurement.

Performance monitoring and evaluation

With the product oriented WBS, the 2 main level elements of the project can be taken down to level 3 comprising handrails, skid frame, pipe supports and pipe spools 1, 2, 3, etc and progress tracked both in terms of schedule and cost.

References

Humphreys, G. C. (2011). Project Management Using Earned Value, Project Management Using Earned Value  (2nd ed.), (PP. 31-42) CA, Humphreys & Associates,  Inc.

Humphreys, G. C. (2011).  Definition of Scope, Work Breakdown Structure (WBS) and WBS Dictionary,  Project Management Using Earned Value  (2nd ed.), (PP. 45-58) CA, Humphreys & Associates,  Inc.

Humphreys, G. C. (2011). Relating Organisations, Responsibility, and Work Scope, Project Management Using Earned Value  (2nd ed.), (PP. 91-100) CA, Humphreys & Associates,  Inc.



2 comments:

  1. AWESOME posting, Charles!!!! You followed our step by step analysis perfectly, and your citations were spot on!!!

    Really nice work, Charles and I would hope that you will take a few minutes of your time to mentor Stella and Segun. They are not clear on what I am looking for and you seem to have grasped it well.

    My only suggestion would be to expand on this excellent case study and compare some of the other options presented to us using Omniclass. What about by Discipline? Or Phase? Or Component? My suggestion would be to take this same case study approach and do the same for the Norsok Z-014 and as many of the Omniclass Tables you think make sense. Using the same approach, compare and analyze them to see which ones might be worth exploring more. (W3, W4 and maybe even W5 blog posting. In the last blog posting, summarize what you have discovered and make your recommendations.

    I think that will be a great paper!!!

    BR,
    Dr. PDG, Singapore

    ReplyDelete
  2. Dr PDG
    Are you suggesting i replace my paper topic Application of Earned Value Management in Fabrication Yard Management with Analysis of various oriented WBS as a tool in Earned Value Management. This is worth exploring.
